St. Ignatius School District Outbuilding
/ Pam ReedFinal walk-thru/substantial completion - January 6, 2021
Status of Project - December 21 - December 31, 2020 - Finishing up, fine tuning and taking care of miscellaneous details.
Status of Project - December 18, 2020 - A busy week with the goal to be done before Christmas.
Status of Project - December 11, 2020 - After water issue in crawl space remediated
Status of Project - November 20, 2020
Status of Project - November 13, 2020 - Interior painting complete, rough-in mechanical complete. Electrical rough-in in progress. Drop ceilings scheduled for next week.
Status of Project - November 6, 2020 - Interior painting in progress. Ready to finish rough-in mechanical and electrical.
Status of Project - October 30, 2020 - Drywall, tape completed. Spray texture scheduled for Monday with interior painting planned for Tuesday if all dries.
Status of Project - October 23, 2020 - Drywall in progress.
Status of Project - October 11, 2020 - Exterior paint, insulation, storefront glass, windows, gutters and downspouts complete. Ready for drywall.
Status of Project - September 25, 2020 - Rough-in electrical complete and inspections approved for HVAC plumbing, and electrical. Storefront glass, windows, rigid insulation, siding and trim has begun.
Status of Project - September 17, 2020 - Rough-in plumbing and HVAC complete. Rough-in electrical began early to be completed next week. Roof installed. Next week, door frames and siding installed.
Status of Project - September 11, 2020 - Rough-in plumbing and HVAC. Next week begins rough-in electrical, roof installation, and fabrication of window frames.
Status of Project - September 4, 2020 - Rough in mechanical and plumbing begins next week.
Trusses delivered August 31, 2020. Status of project end of day August 31.
Week of August 10, 2020 - Framing began Tuesday afternoon. Ready for trusses on Friday afternoon. (Truss install delayed until August 31, 2020 due to availability of crane)
Week of August 3, 2020 - Sidewalk and stair prep, backfill, poured sidewalks and stairs. Reading for framing.
Installed water line to curb stop, installed sewer line to existing, backfilled and compacted to foundation, prepped for sidewalks, landings and ramp. July 20-29, 2020 - PLEASE NOTE THAT PHOTOS ARE TAKEN BY VARIOUS SOURCES AND MAY NOT BE POSTED IN THE ORDER THE WORK OCCURRED
Poured footings, formed and poured walls, stripped walls, damp proofed, and concrete sealed top 12 inches of foundation wall around perimeter. All testing completed. July 13-17, 2020

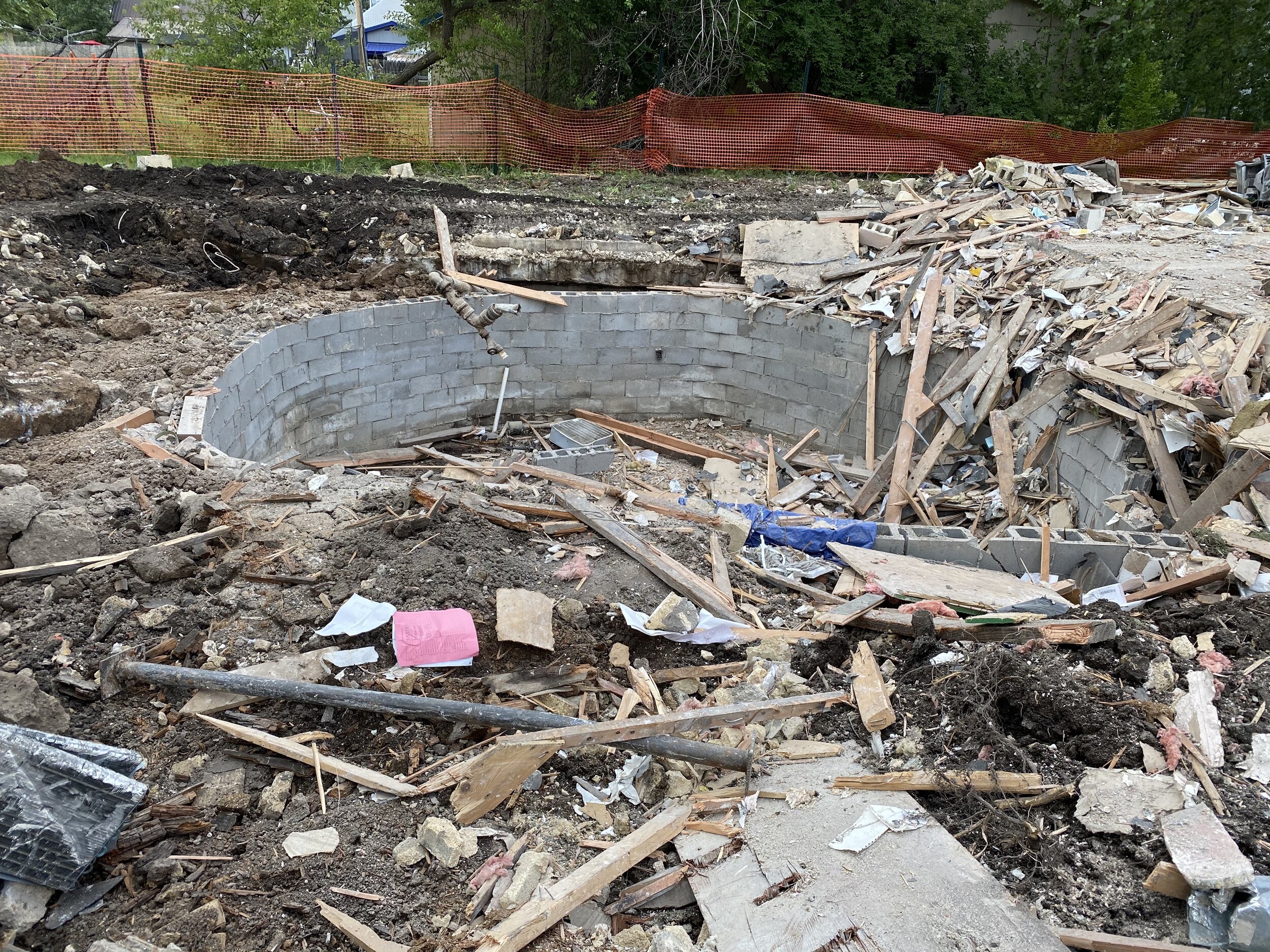

Prep site for footings/foundation. Compaction testing complete. Footings being prepped July 10 for pour on July 13 - July 6-9, 2020
Mobilization and Demolition - June 30-July 3, 2020

June 20, 2020 - Recovery of Refrigerant
June 17, 2020 - Pre-Construction Photos - Building to be Demolished
ARCHITECT:
Slate Architecture
Jacob Augenstein
1470 N. Roberts Street
Helena, MT 59601
406.457.0360
jacoba@slatearch.com
MEP ENGINEER:
Associated Construction Engineering
Missoula, MT
Jared Swartz
406.549.4160
STRUCTURAL & CIVIL ENGINEER:
RPA ENGINEERING
Helena, MT
Craig Jenneskens
406.447.5000
THANK YOU TO OUR SUBCONTRACTORS AND VENDORS:
BMC (Material, Trusses)
Bauska Painting
Buhler Construction
Counter Solutions
Creative Paint & Glass (Storefront Glass & Hardware, Glazing)
High Country Gutters
Holman Consulting Engineers (Testing)
Granite Door Company
JDA Construction (Roofing)
Jace Johnson Construction
Loren’s Carpet One
Lynch Insulation
Montana Doorways Plus (Division 10)
Northwest Interior Contracting Inc.
RV Douglass (Demolition & Excavation)
Redkey Refrigeration
Snow Mountain Electric
Stensrud Cabinets
TOF Construction and Remodel
Whetzel Concrete Company
